Construction Updates
Monthly Construction Updates - 2024/2025

Monthly Construction Updates - 2024/2025

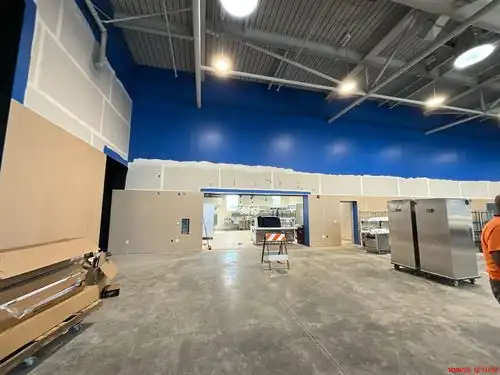

October 2024
Hillview JHS Replacement Campus Project

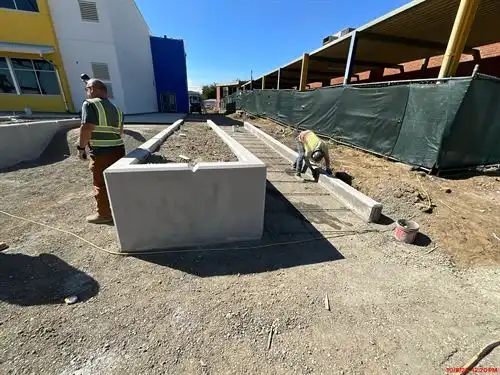

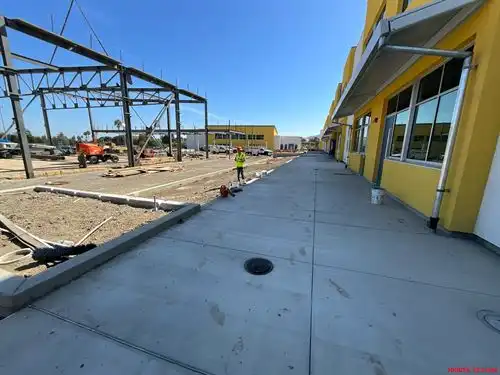

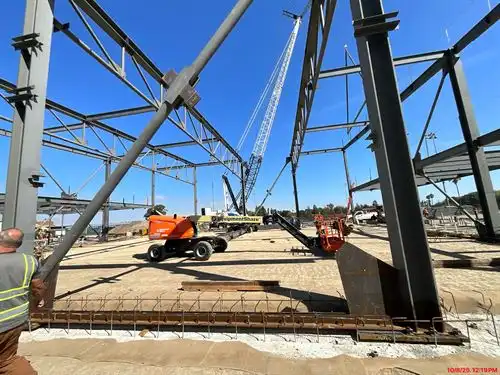

The Hillview Project is well underway. Building footings and slabs have been poured and steel is now being erected on the new Multi-Purpose Room.
The Hillview Project is well underway. Building footings and slabs have been poured and steel is now being erected on the new Multi-Purpose Room.

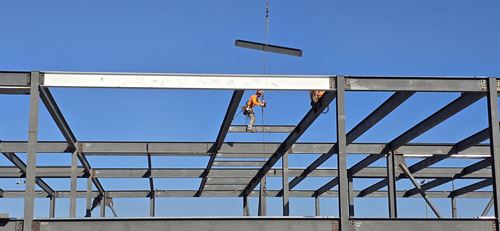

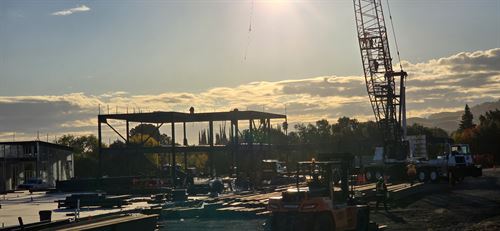

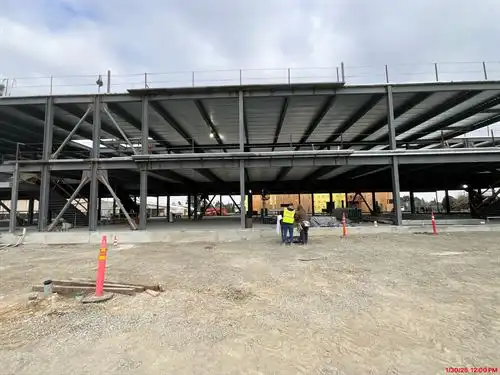

Multi-Purpose Building Steel Erection

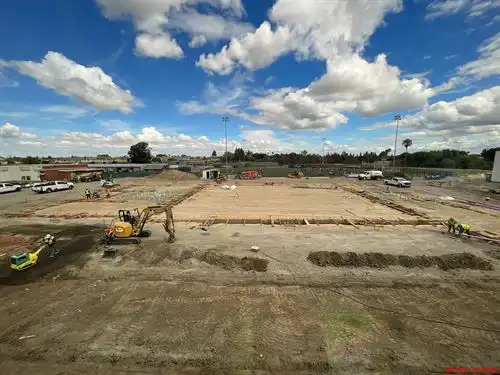

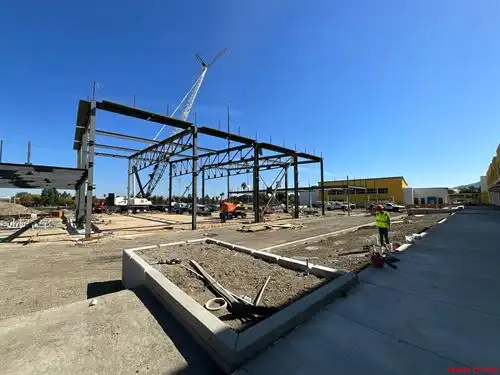

Hillview Building A Footings

Hillview Groundbreaking Ceremony - September 2023

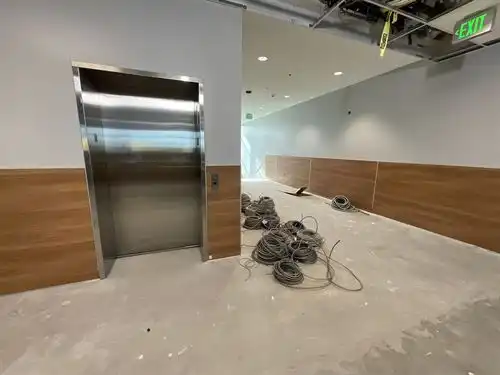

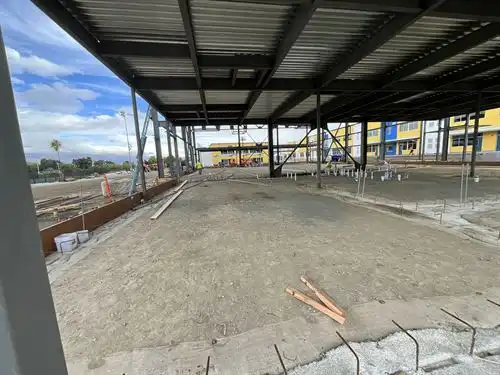

November 2024

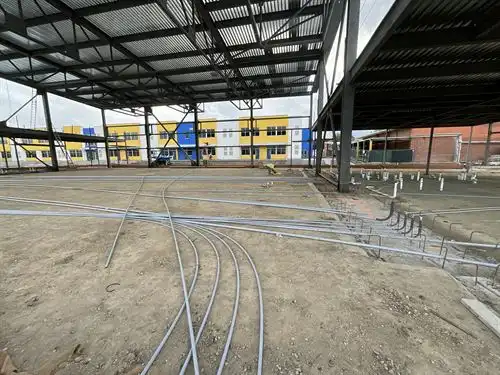

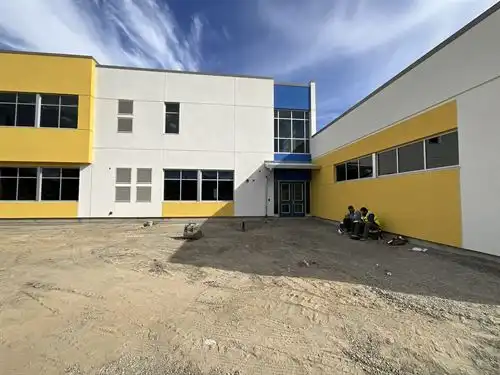

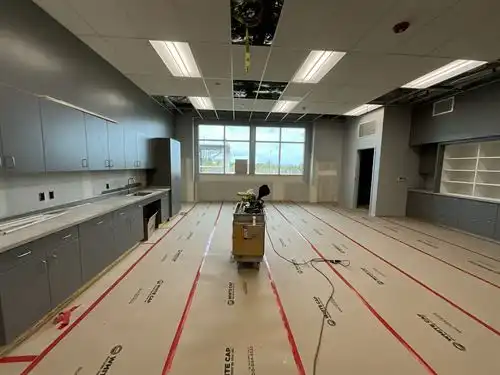

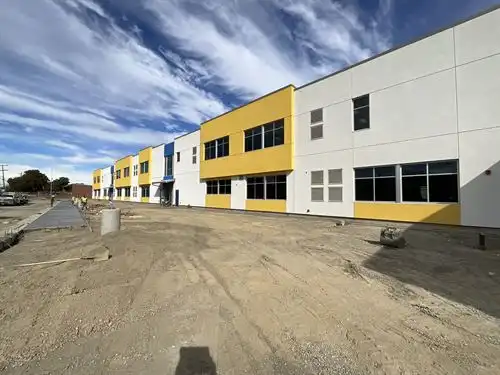

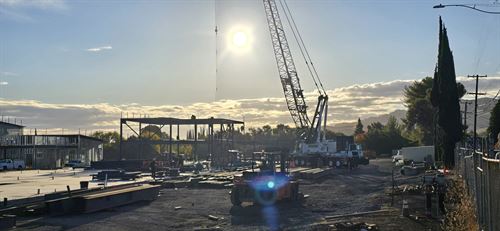

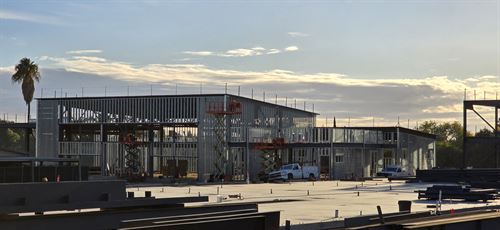

Pictures from November 15th. Framing is moving along as well as steel erection.

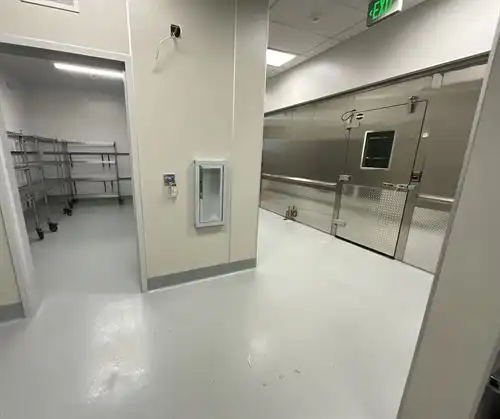

December 2024

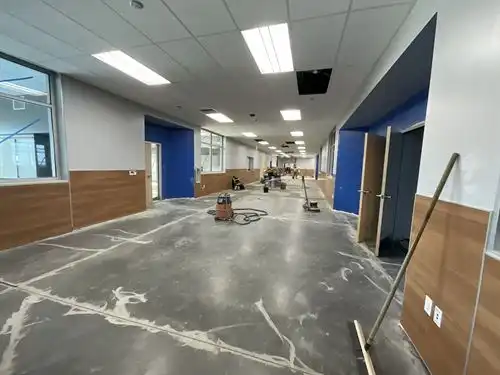

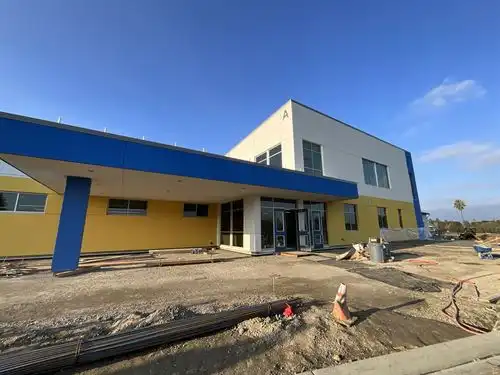

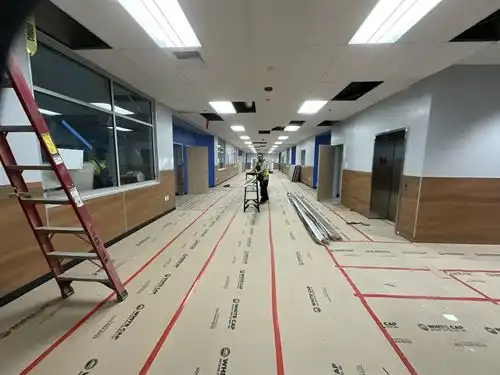

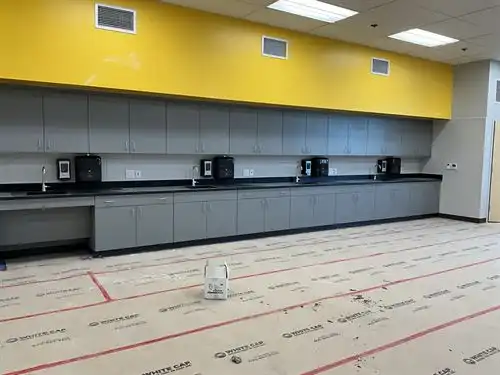

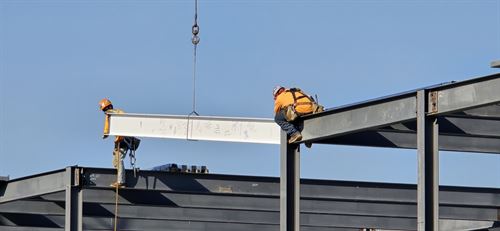

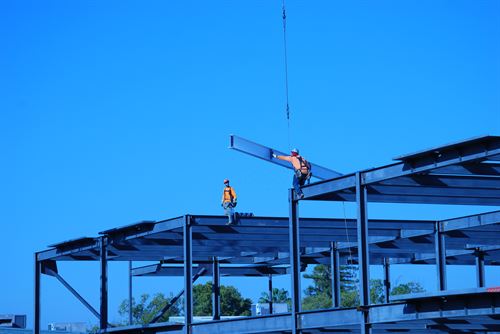

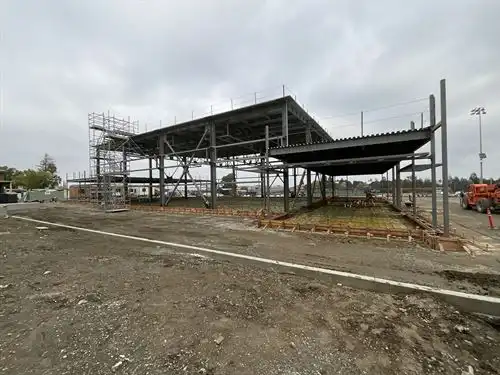

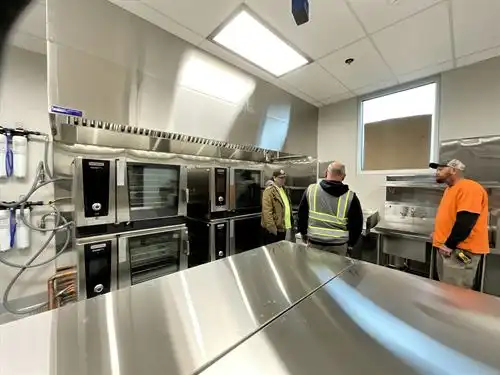

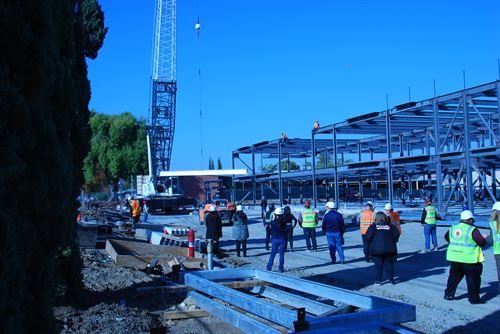

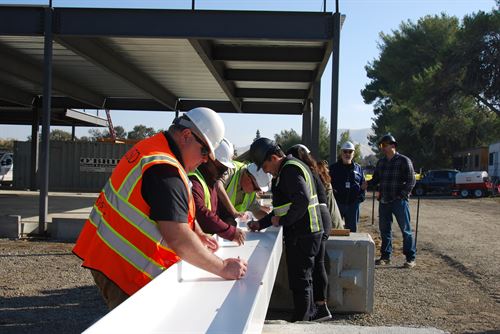

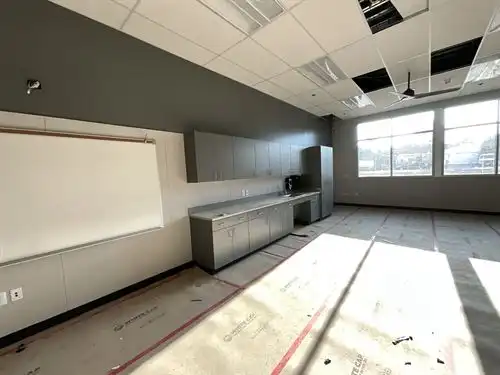

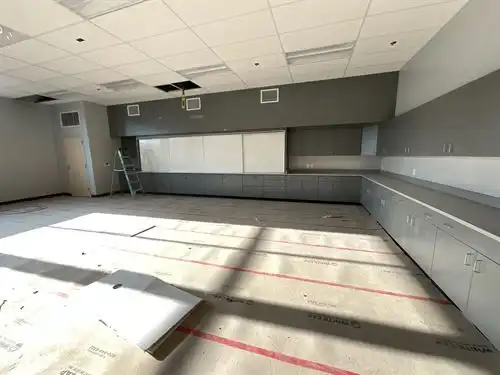

On December 3rd, the last steel beam was placed. An informal Final Steel Beam Signing & Steel Top Out Event was held. The project is coming along nicely.

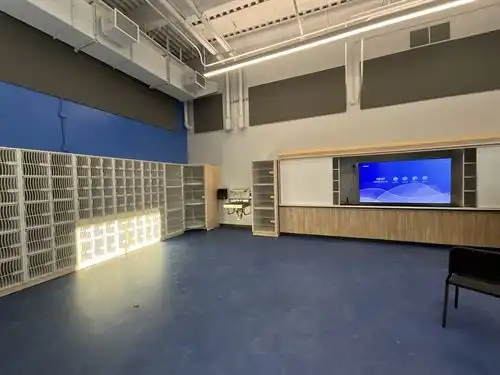

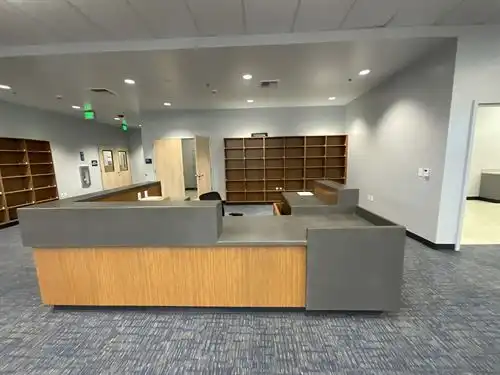

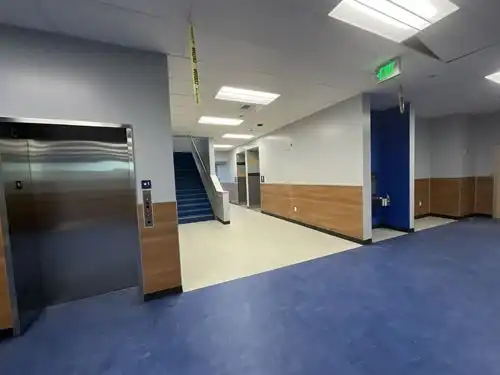

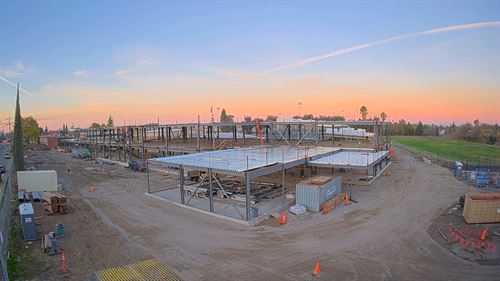

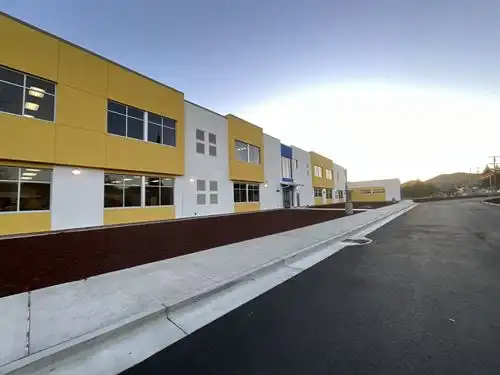

January 2025

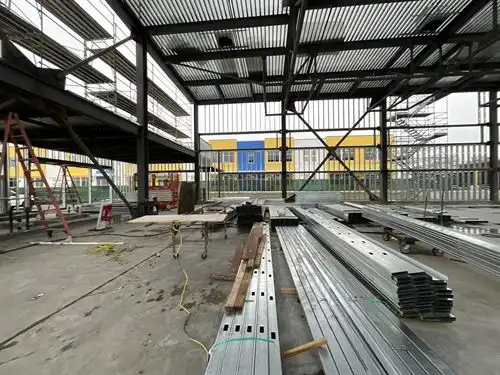

Pittsburg Unified's main project, the Hillview JHS Replacement Campus Project, is coming along. Although there was some rain over the past month, a lot of progress still has been made with the steel construction.

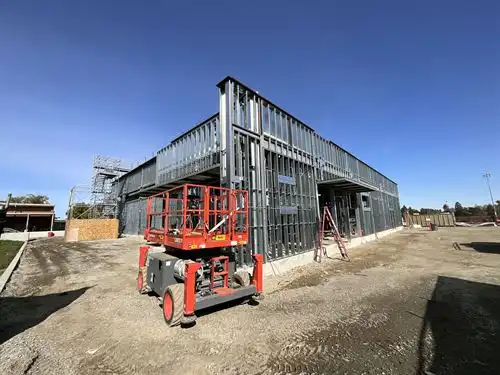

February 2025

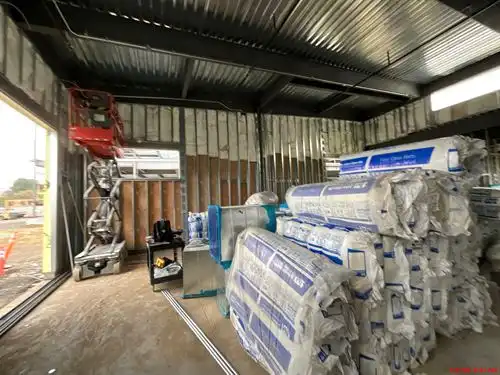

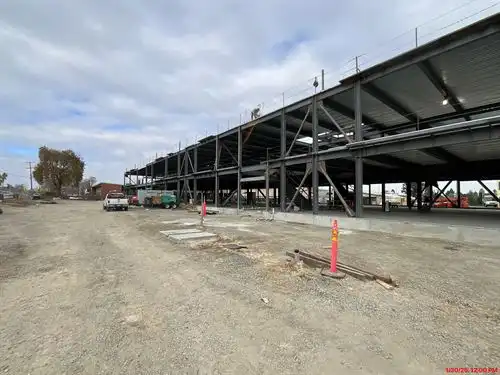

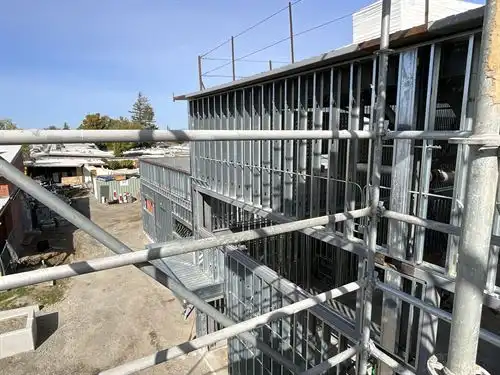

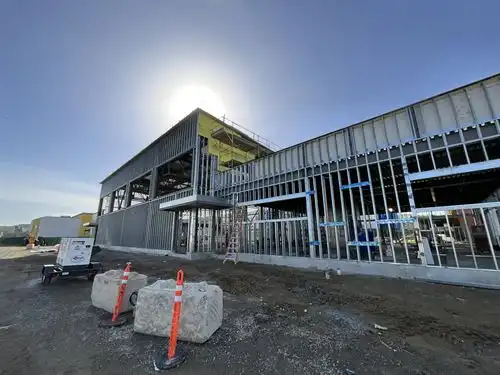

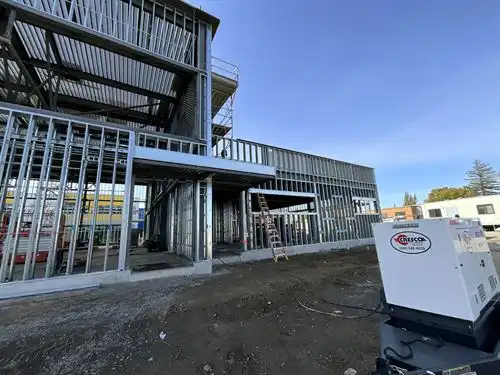

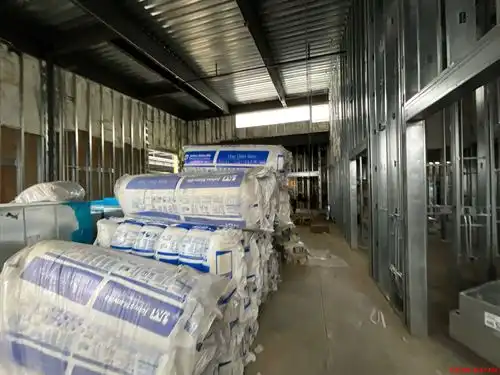

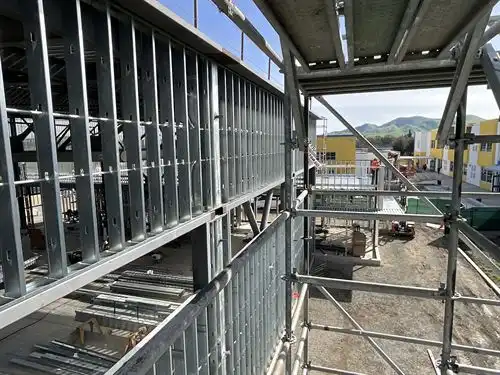

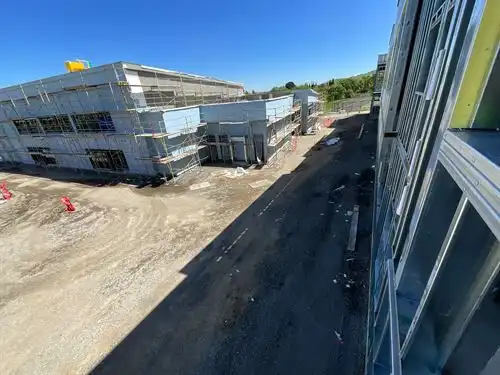

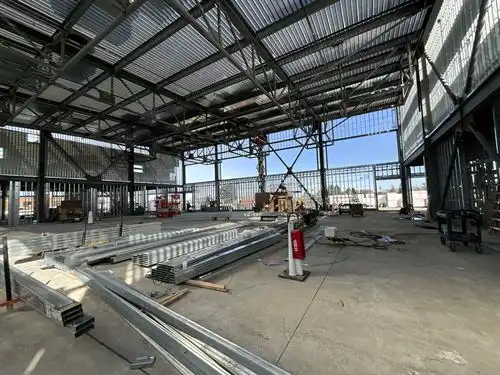

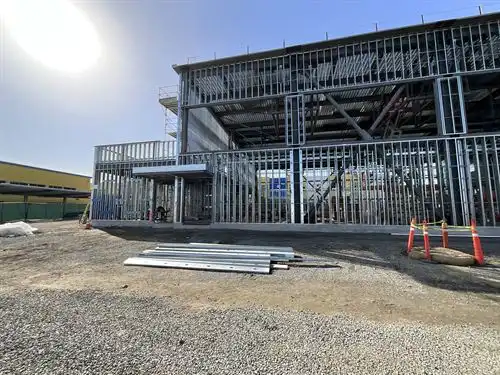

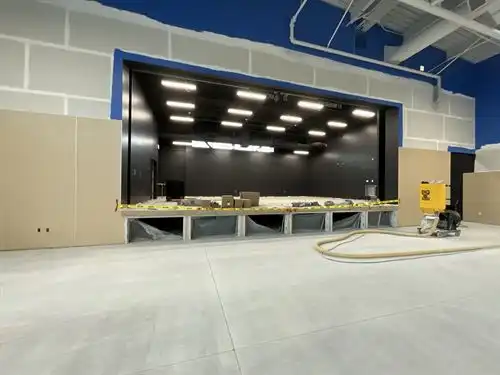

Hillview JHS Replacement Campus Project Updates: Building A (Classroom/Admin Building) is framed up. Building B (MPR) is buttoned up and insulation and drywall are being installed inside. Sitework has started as well.

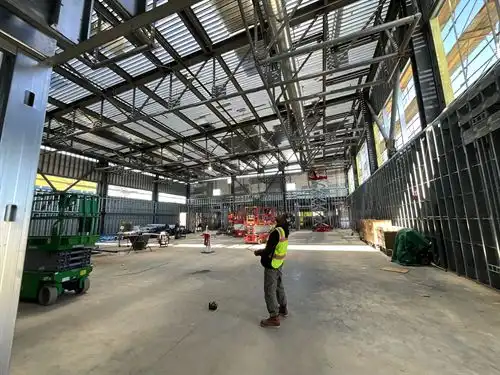

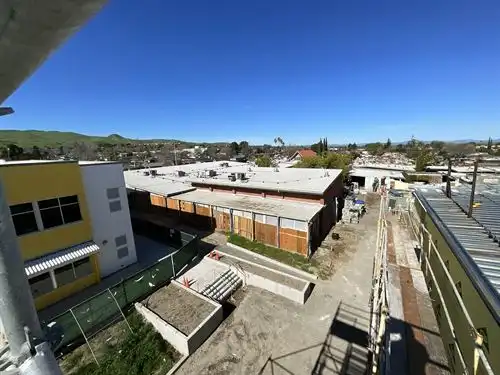

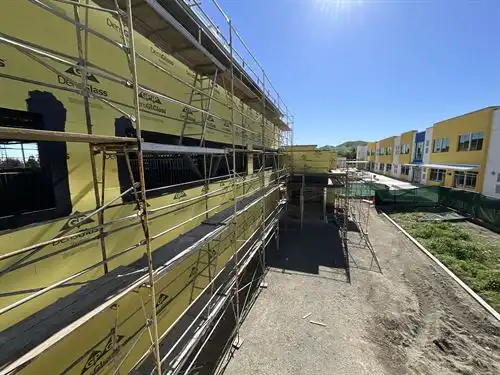

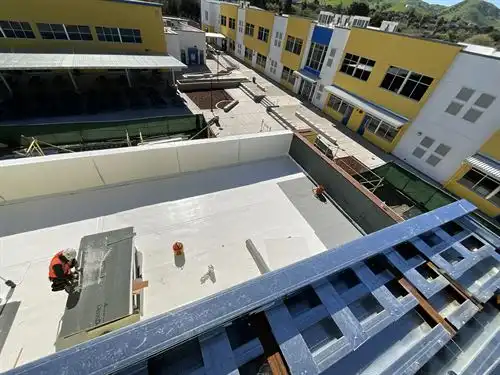

March 2025

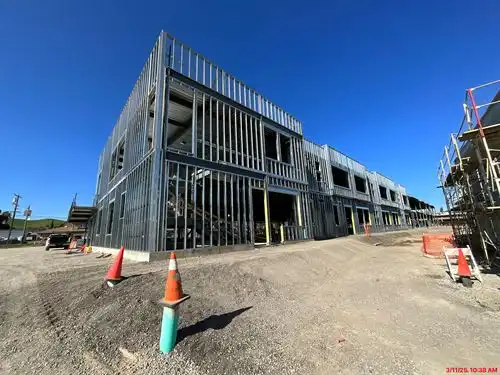

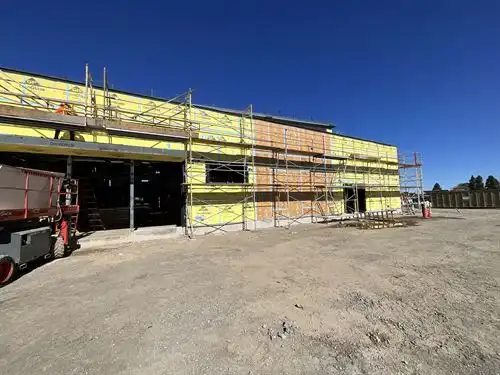

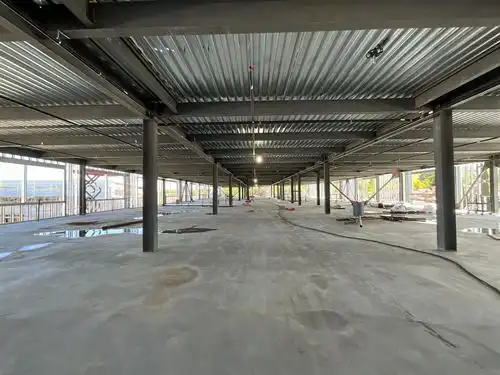

Hillview continues to move along.

April 2025

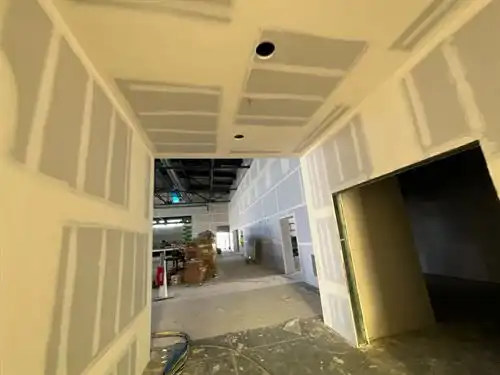

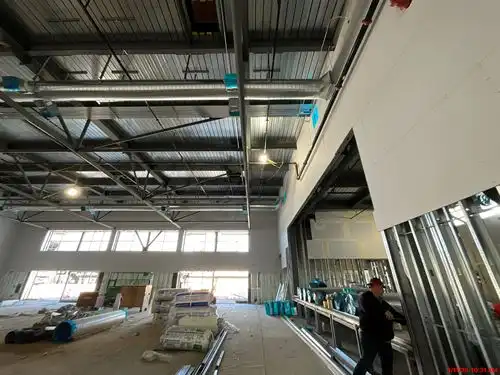

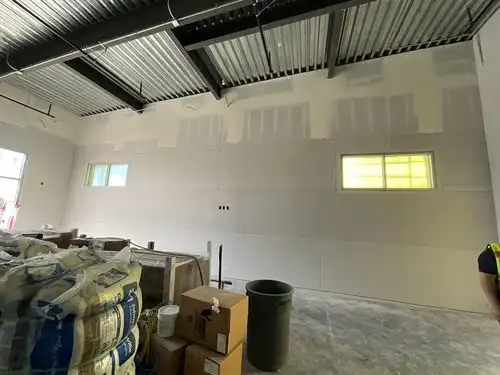

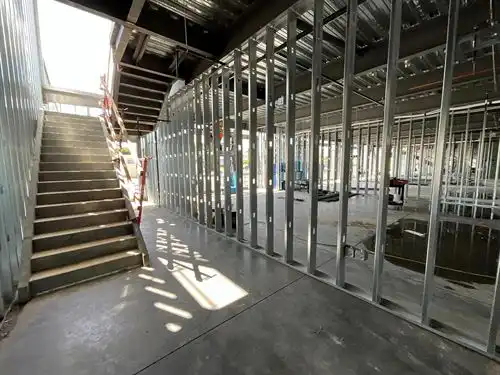

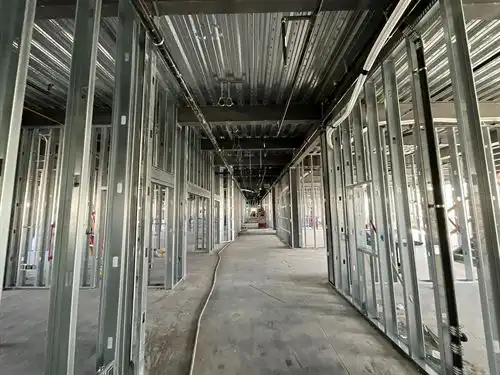

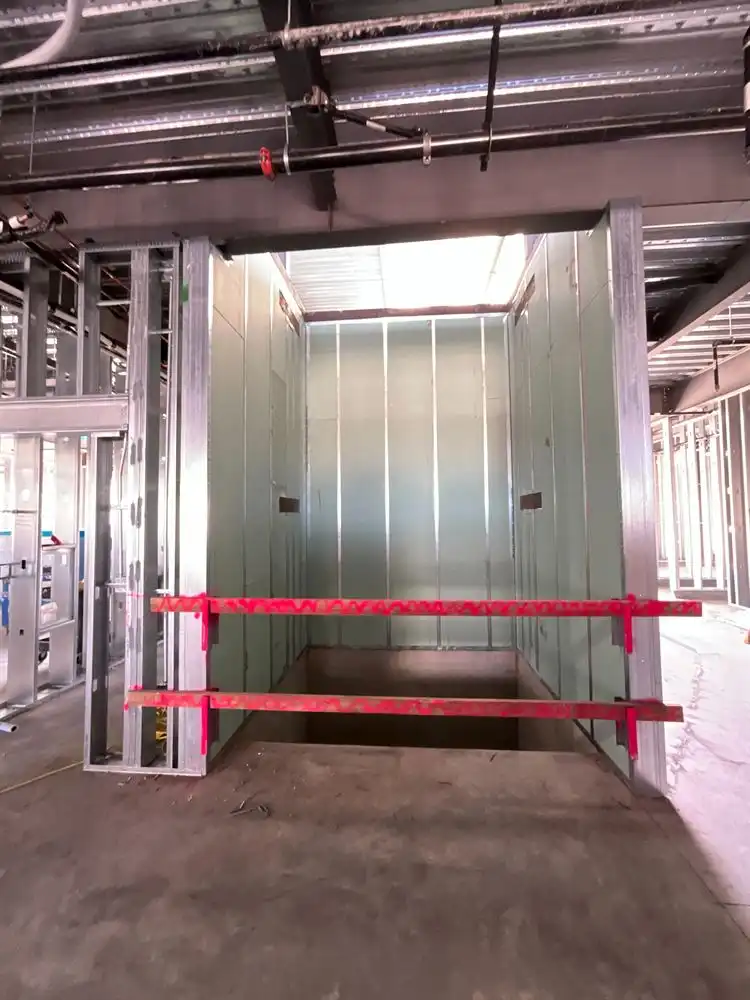

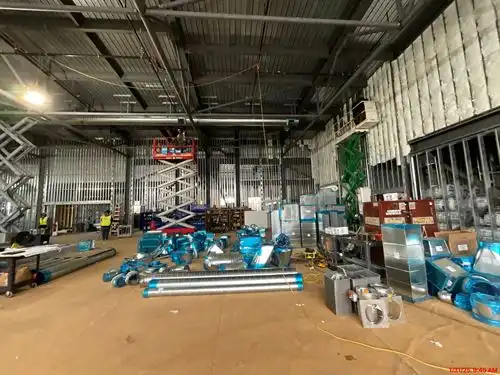

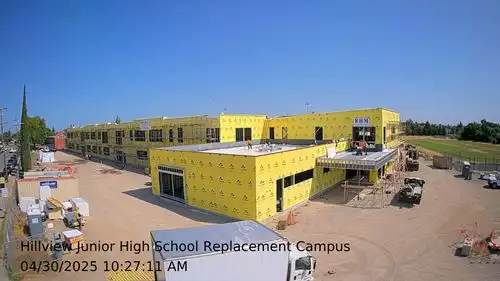

The construction at Hillview JHS is moving along at a good pace. The interior work is picking up with much of the steel studs being installed. The siding to the MPR is being installed.

May 2025

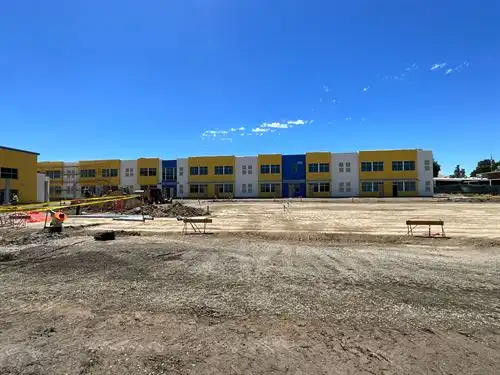

- The new Multi-Purpose Bldg. (Bldg. B) is about 75% complete, with the exterior finish receiving the colors coats and the interior painting beginning. This building should be near 100% complete this coming September. This building is still on schedule to be fully completed in late November/early December so that the District can then occupy and utilize the facility when the 2025-2026 school year resumes in January 2026.
- The new Admin./Classrooms Bldg. (Bldg. A) is moving along quickly and is about 40% complete. The exterior finish insulation has been installed on the entire building, the main roof is mostly complete, and the lower roofs are in progress. The interior framing is nearly complete, and gyp. board installation has begun. This building is still on schedule to be completed in late November/early December so that the District can then occupy and utilize the facility when the 2025-2026 school year resumes in January 2026.

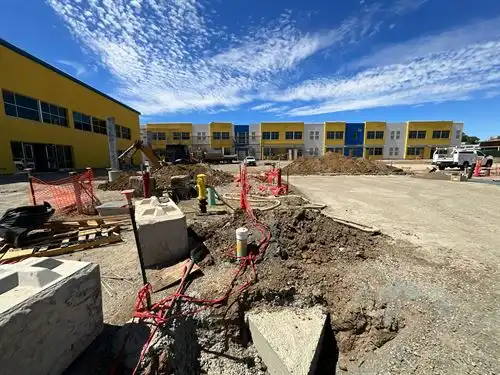

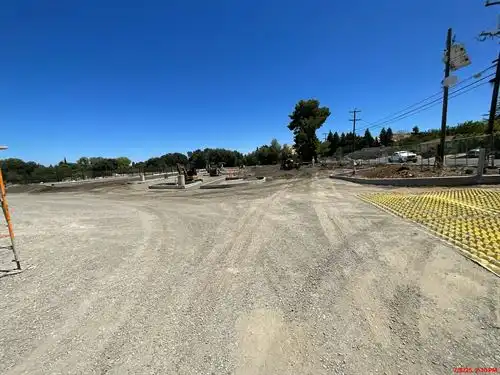

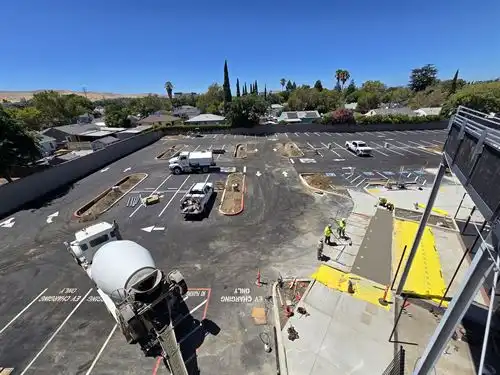

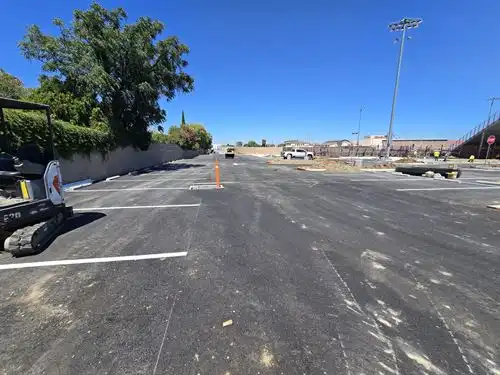

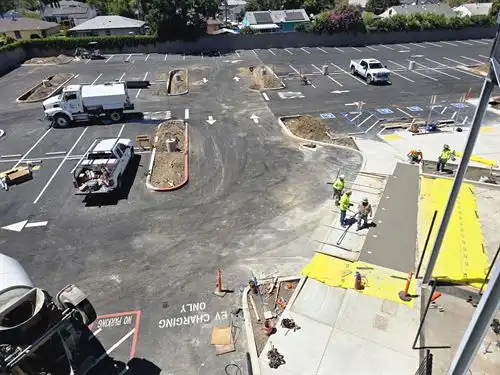

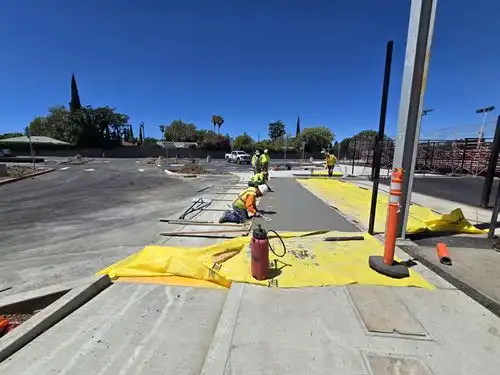

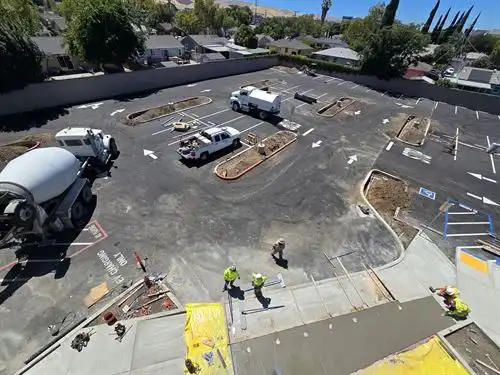

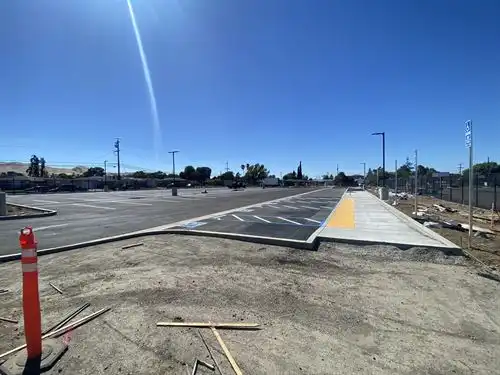

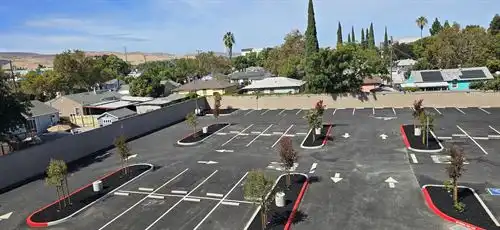

- Construction of the Public Parking Lot, along with associated hardscape & landscape work, will begin in late May/early June and then be completed in October.
- The new Gym. & Locker Rooms Bldg. (Bldg. C) will be under construction starting this August/September after the existing Gym. & Locker Rooms Bldg., and the existing Cafeteria/Kitchen & MP Bldg., have been demolished. This building is still on schedule to be completed in late July 2026 so that the District can then occupy and utilize the facility when the 2026-2027 school year begins in August 2026.
- Construction of the Staff Parking Lot and AC Paved Playyard, along with associated hardscape & landscape work, will begin in late March 2026 and then be completed in mid-June 2026.

June 2025

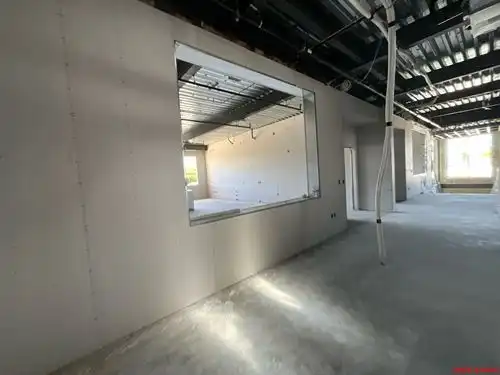

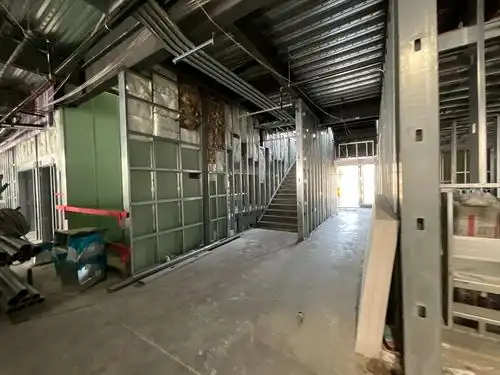

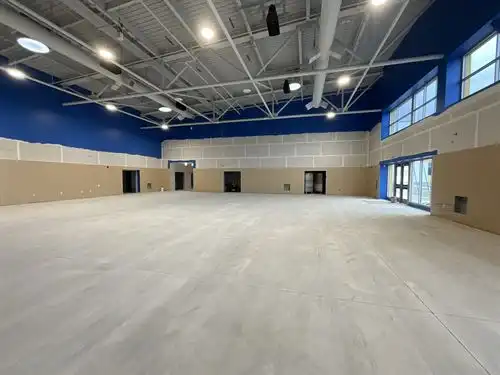

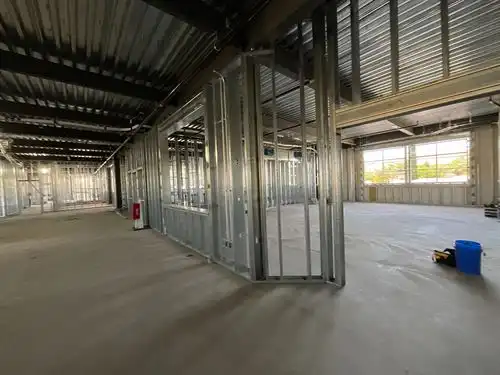

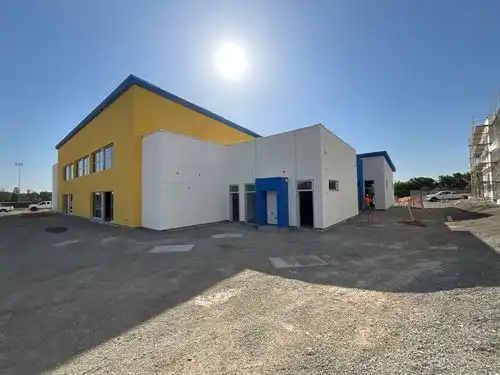

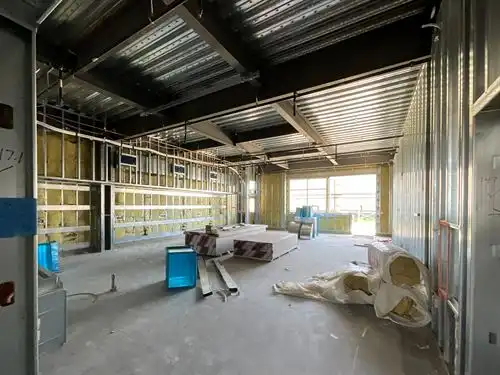

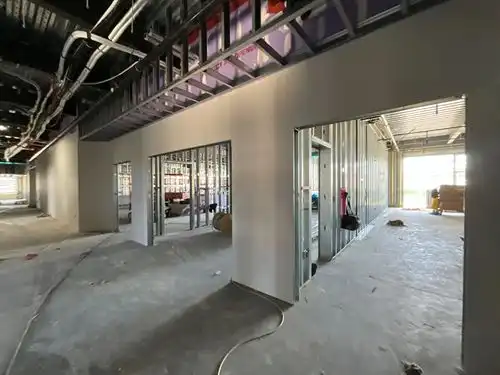

Mainly interior construction work continues on the Multi-Purpose Bldg., as the building's exterior work (including roofing) is basically complete. Door & window frames, and some of the glass, have been installed, walls have been closed up & painted, and some floor finishes have been installed. This building is still on schedule to be 95% complete in late August/early September, with full completion by early December for occupation by the District over this year's Christmas & New Year Holidays Break.

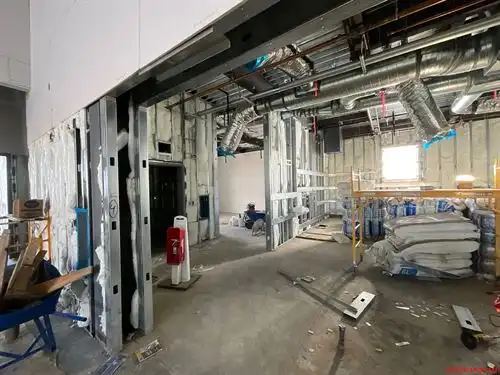

At the new Admin./Classrooms Bldg., both exterior walls and interior walls construction is ongoing. Roofing is basically complete. Utilities rough-in work is ongoing inside of the building, most of the interior walls have been framed, and some walls have been closed up. This building is currently still on schedule for occupation by the District over this year's Christmas & New Year Holidays Break.

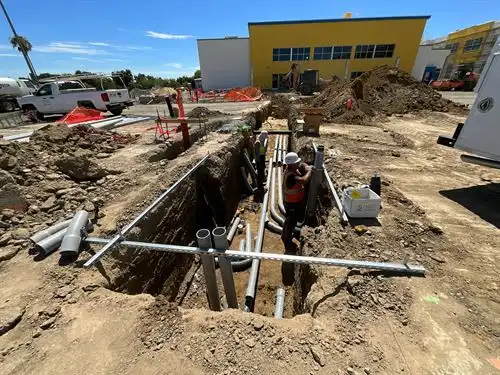

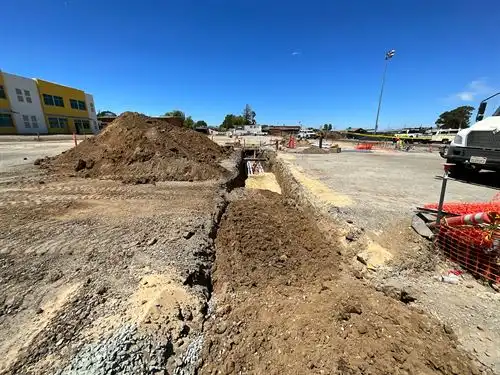

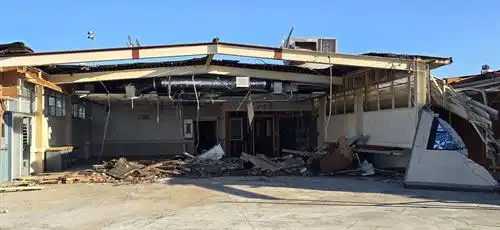

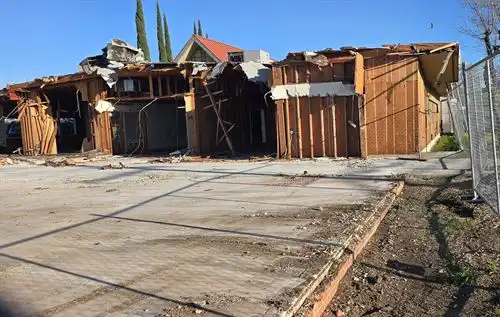

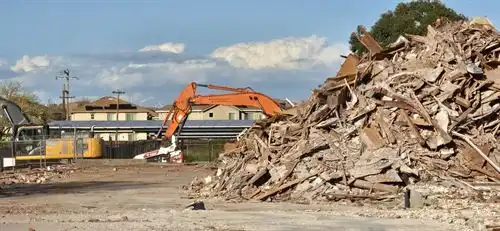

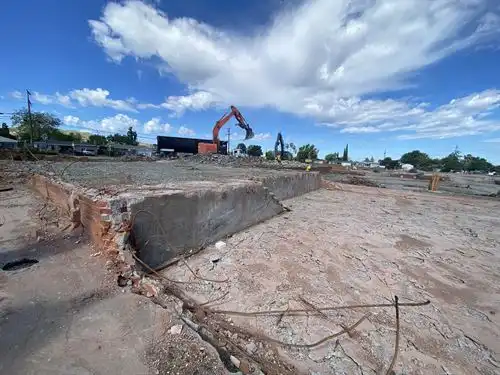

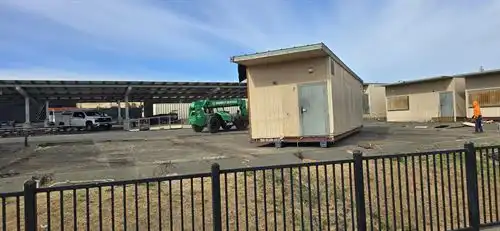

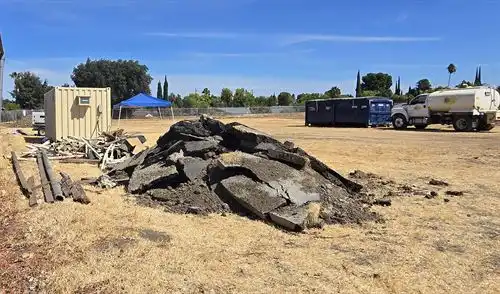

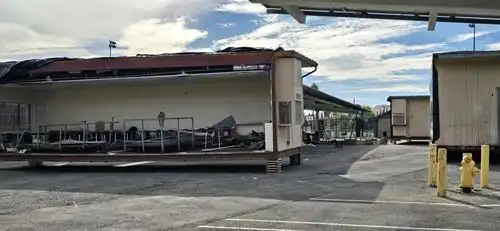

The existing Gym. & Locker Rooms Bldg., and the Cafeteria/ Kitchen & MP Bldg., has now fully been cleared of hazardous materials, and the demolition of these buildings will begin on 06/16/25. After demolition is completed, construction work will begin on the new Gym. & Locker Rooms Bldg. This building is currently scheduled for completion in July 2026.

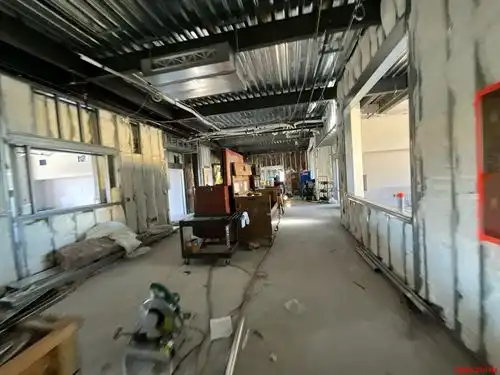

July 2025

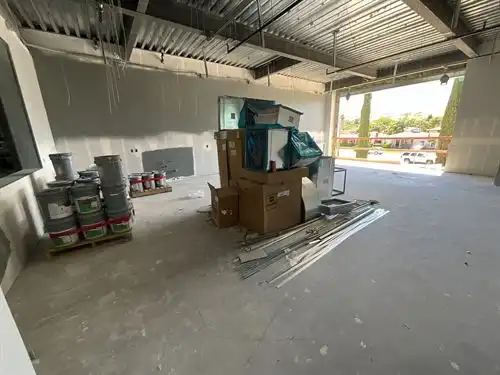

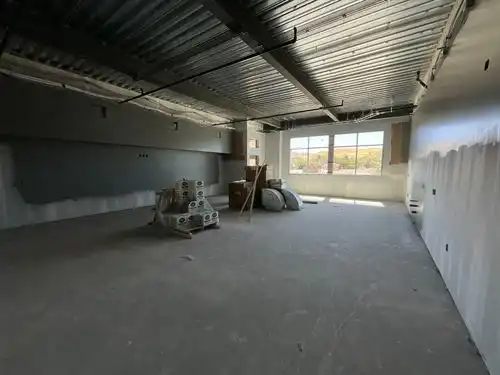

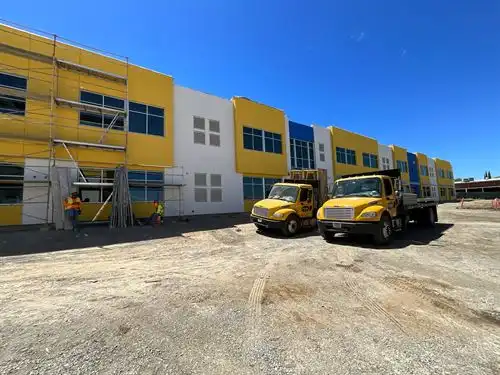

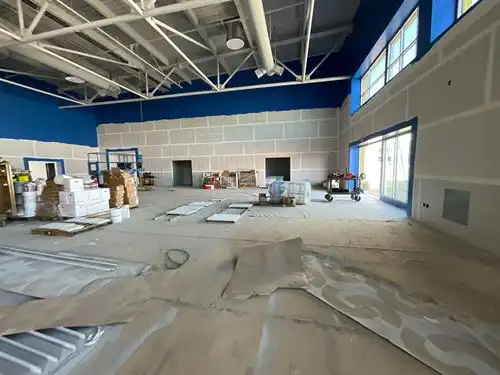

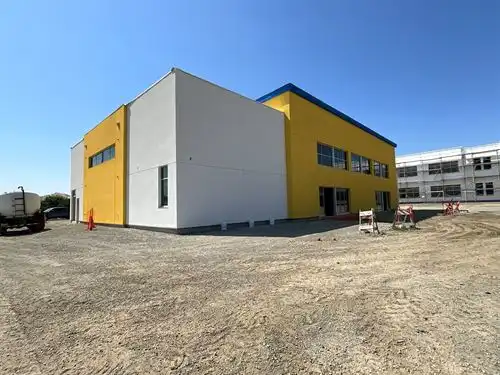

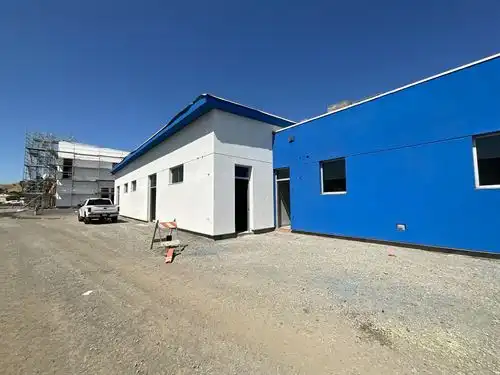

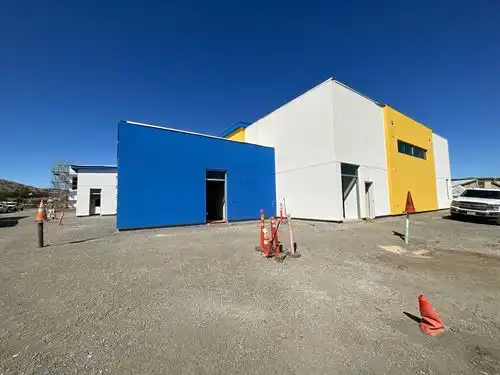

The new Multi-Purpose Bldg. is approximately 85% complete with all of the exterior finishes completed, and with the majority of the interior finishes also completed. This building is still scheduled to be 98% complete in late August, and still scheduled to then be 100% complete in early December.

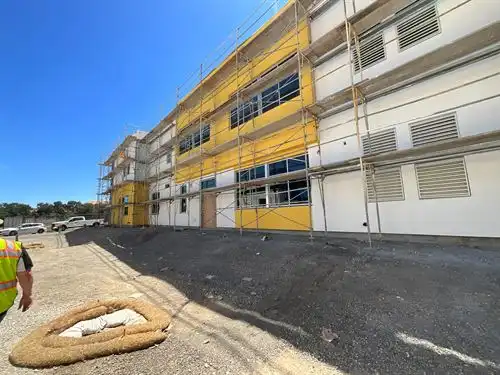

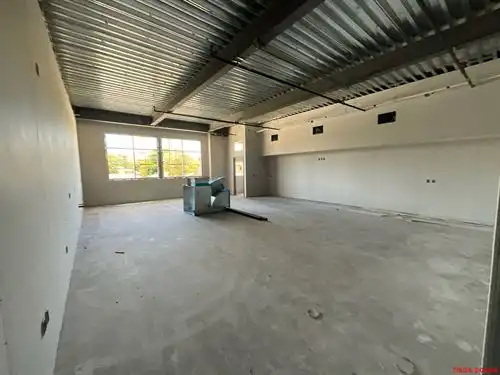

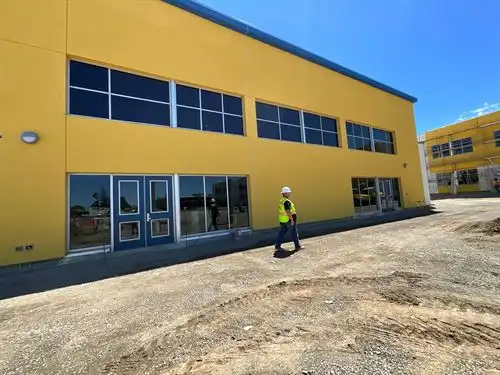

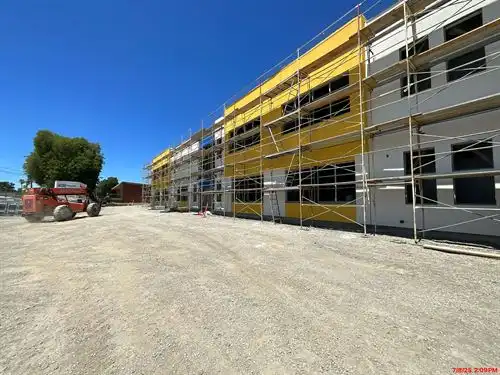

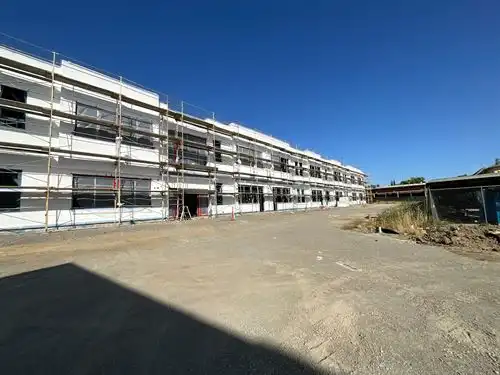

The new Admin./Classroom Bldg. is approximately 65% complete with about 75% of the exterior finishes completed, along with a good amount of the interior finishes also completed. This building is still scheduled to be 100% complete in early December.
The hardscape & landscape work around the new Multi-Purpose Bldg. and the new Admin./Classroom Bldg. is still scheduled to be 100% complete in mid-December. The District is still on schedule to move into and occupy the new Multi-Purpose Bldg. and the new Admin./Classroom Bldg. over this year's Christmas & New Year Holidays Break.

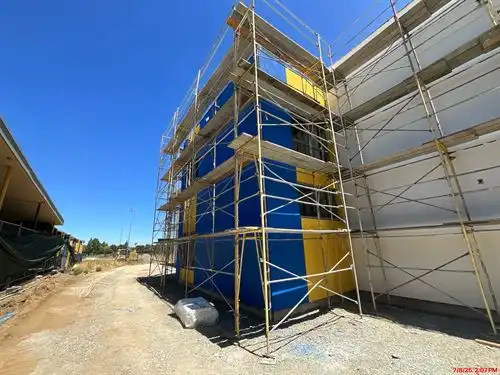

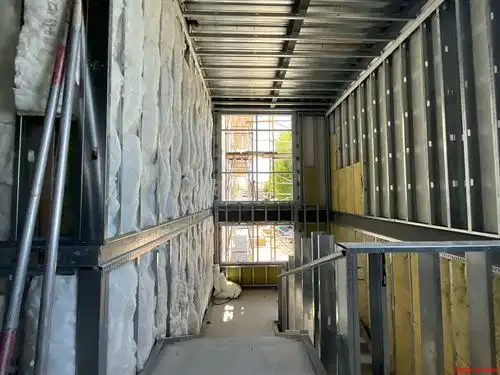

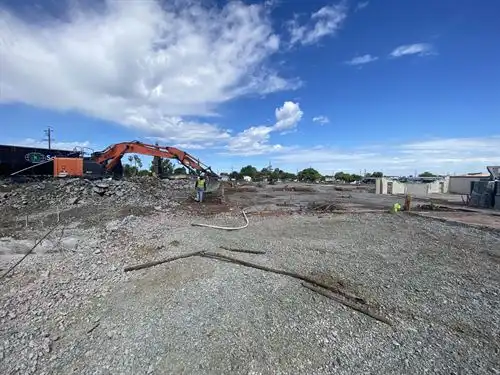

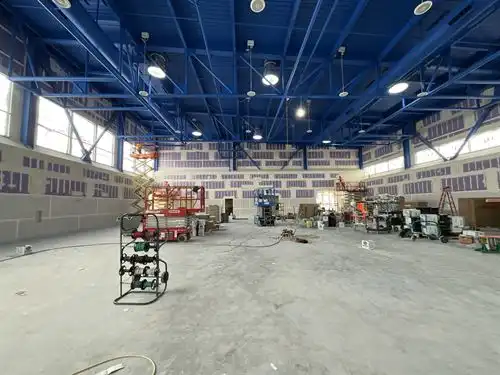

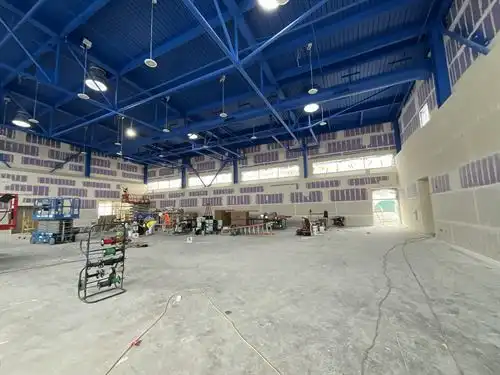

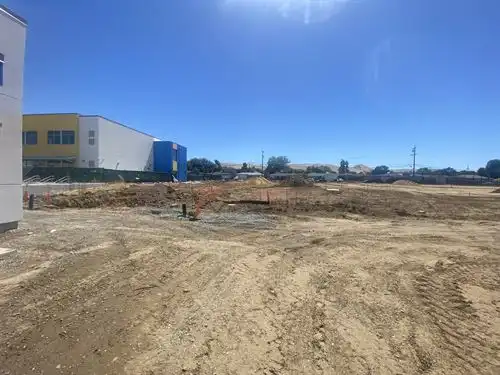

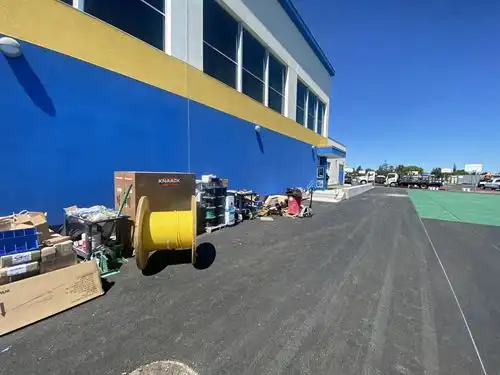

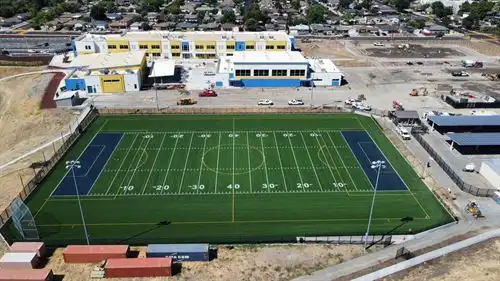

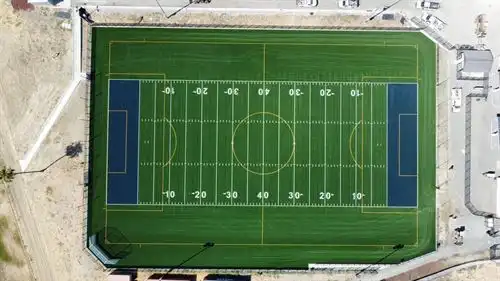

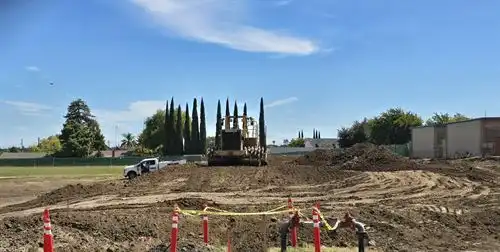

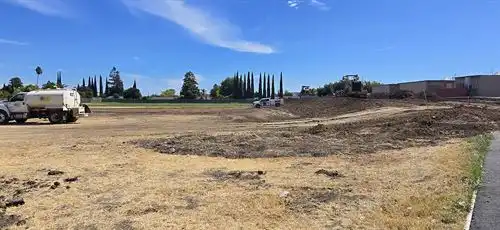

The existing school facilities are scheduled to be abated & demolished by late April 2026, which will then allow for construction of the Staff Parking Lot and the AC Paved Playyard. Construction of the new Gym. & Locker Rooms Bldg. can now begin, and will start in earnest this month. It is anticipated that the slab will be completed in early November, and that the structural steel will be completed in late December. This building is scheduled to be 100% complete in late June 2026. All hardscape & landscape around the new Gym. & Locker Rooms Bldg., and for the entire Project, is scheduled to be 100% complete in mid to late July 2026.
